← Residual Research

The Last Western Dependency

The Last Western Dependency

The same engine programme that loosens Airbus’s near-term constraint removes the chokepoint that kept COMAC bottlenecked.


COMAC delivered fifteen C919 narrowbodies in 2025. The target was seventy-five. Beijing’s response, published today in the 15th Five-Year Plan, was to accelerate the CJ-1000A, the domestic engine that eliminates the C919’s dependence on Western suppliers.1

For Airbus, the implications fork. Near-term, every CJ-1000A that replaces a LEAP-1C frees an engine for CFM’s other customers, including the A320neo. Long-term, a COMAC that no longer needs US export licences is a COMAC whose production ceiling is set by Chinese industrial capacity, not American trade policy. The engine pool that was already binding loosens. The competitor unshackles.

I. The constraint

In January 2025, COMAC targeted 30 C919 deliveries. By March: 75. By September: 25.2 The actual outcome was 15.3

The C919 flies on CFM International’s LEAP-1C, the sole engine option. When the US suspended LEAP-1C export licences in July 2025, production halted.2 Forecast International estimates 55% of C919 component suppliers are US-based; only 25% are Chinese.4 The three carriers that had expected 32 deliveries received five by September.2 Nine of the fifteen came in Q4, after the suspension was lifted.5

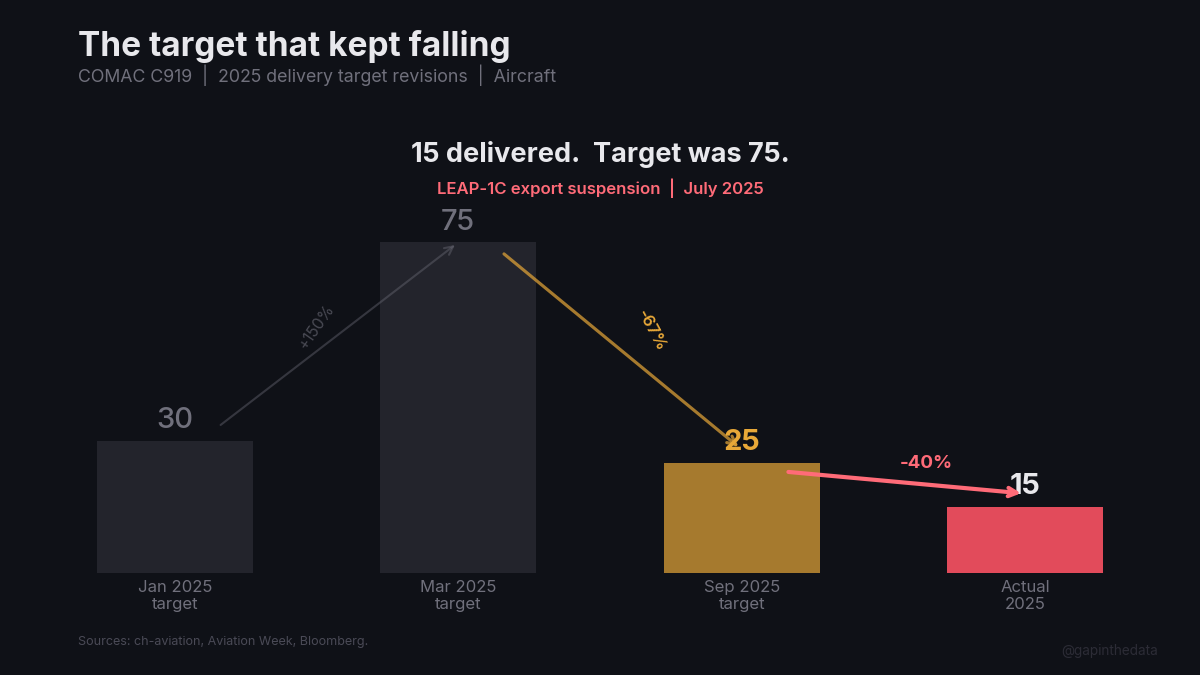

The target that kept falling

The Five-Year Plan did not set a production target. It set a production strategy: accelerate the CJ-1000A, reduce reliance on Western suppliers across engines, avionics, and flight systems, and expand assembly capacity.1

II. The mechanism

The CJ-1000A is the domestic engine programme that AECC, the Aero Engine Corporation of China, has been developing since 2016. Design is finalised. AECC is working toward CAAC airworthiness certification. OAG Aviation estimates initial deliveries in 2027 or 2028, with mass production from 2030.6

Brian Yang Bo frames it as a “backup, not replacement.” He adds: “supply-chain stability boils down to this."1 A backup engine that passes CAAC certification is a replacement engine the moment the primary becomes unavailable. The US demonstrated that moment in July 2025, and the export licence regime gives Washington the authority to reimpose it at will.2

Two things were absent from the Five-Year Plan’s engine language. No mention of European certification for the CJ-1000A. No mention of overseas orders for CJ-1000A-powered aircraft. Every confirmed C919 order is from a Chinese entity.7 A CJ-1000A that passes CAAC, without EASA, without FAA, is sufficient for the entire order book.

III. The fork

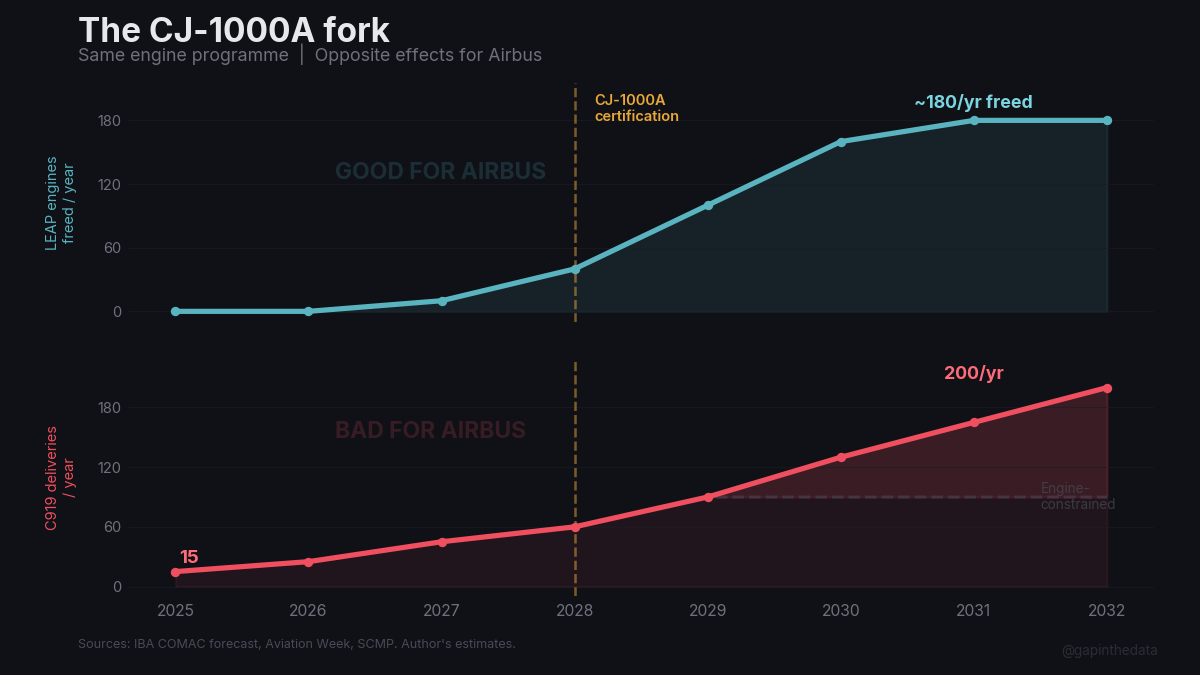

Near-term (2028–2030): the engine pool loosens. In What Safran Can’t Fix, I mapped five claims competing for every LEAP engine CFM builds. Claim 2 was COMAC: approximately 30 LEAP-1C engines in 2025, scaling toward 60–90 per year as production ramps.8 The CJ-1000A removes Claim 2 from the pool.

Those engines do not flow automatically to Airbus. Boeing is ramping the 737 MAX from 42 to 53 per month, each aircraft absorbing two LEAP-1Bs.8 Safran projects LEAP aftermarket revenue will more than triple between 2024 and 2028, targeting propulsion margins of 22–24%.9 Freed LEAP-1C capacity enters a pool where every other claim is also growing. The constraint loosens. It does not disappear.

Long-term (2030+): the chokepoint closes. The July 2025 LEAP-1C suspension demonstrated leverage: Washington could halt C919 production at will.2 With the CJ-1000A in mass production, that lever breaks.

What Airbus loses is not an engine allocation. It is the fact that its largest emerging competitor was bottlenecked by a dependency the West controlled. IBA forecasts 90 C919 deliveries per year by 2030, engine-constrained.10 Remove the bottleneck and the constraint shifts to what China controls: final assembly capacity, airframe supply chain, political will. The Five-Year Plan targets assembly capacity expansion and indigenisation of avionics and flight systems alongside engines, addressing each remaining constraint by name.1 The domestic market alone, 9,500 new aircraft over twenty years per Faury’s own estimate, sustains the programme without a single export order.11

The CJ-1000A fork

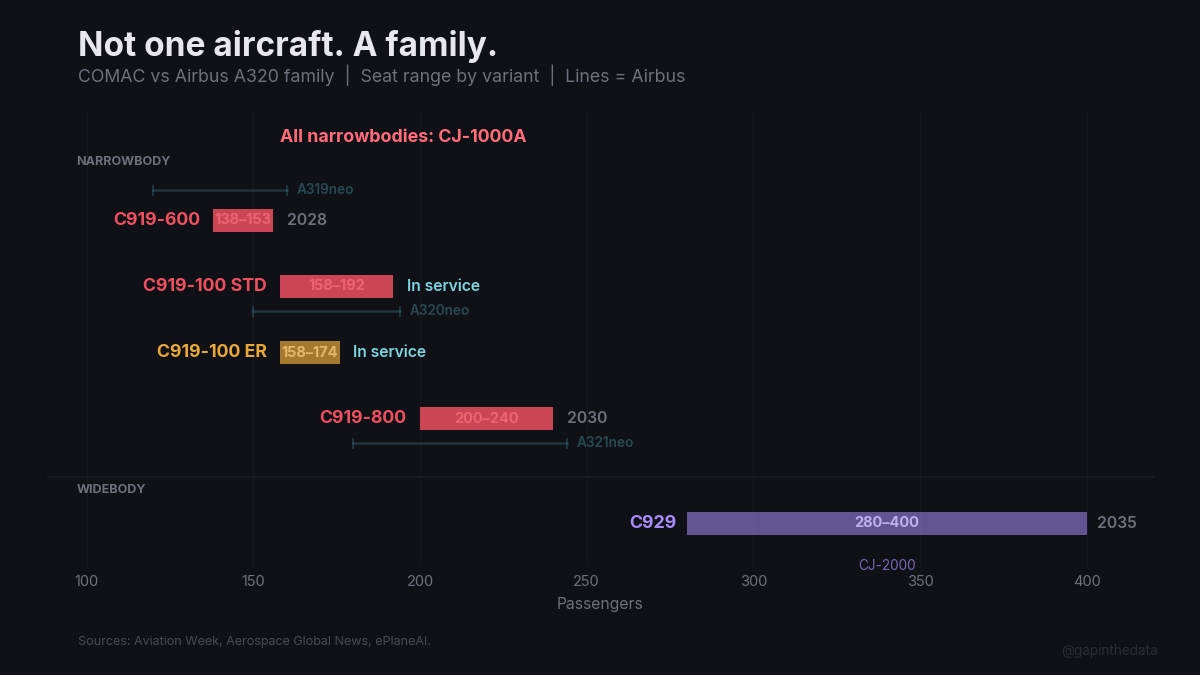

COMAC has built a three-variant narrowbody family in two years: the standard C919, a shortened C919-600, and a stretched C919-800.12 13 14 The family covers 138 to 240 seats, and the CJ-1000A powers all of it, enabling a production programme that could exceed 200 aircraft per year.

The COMAC narrowbody family

Transition (2028–2032). Early CJ-1000A-powered C919s will fly alongside LEAP-1C aircraft, the ratio shifting as AECC scales. How CFM manages a winding-down LEAP-1C customer, reallocating to LEAP-1A and LEAP-1B or absorbing the decline, shapes how much of the freed pool reaches other customers.

The risk. The fork’s long-term arm depends on the CJ-1000A working. If the engine arrives late, underperforms, or carries reliability penalties, the LEAP-1C dependency persists and the fork collapses to its near-term arm only. China has not previously mass-produced a commercial turbofan at this thrust class. C919 utilisation sits at 2.6 hours per day against a narrowbody benchmark of seven; the aircraft is immature even with proven Western engines.10 The Five-Year Plan is a statement of intent, not a statement of capability.

IV. The propulsion vector

AVIC co-funded AECC with $7.5 billion in 2016.15 AECC builds the CJ-1000A. AVIC is simultaneously Airbus’s largest non-engine supplier, producing sole-source A350 composite structures and A320 wing components, and, since July 2025, equipping A321 fuselages at Tianjin.16

The CJ-1000A has completed flight testing on Y-20 transports. AECC’s Wu Guowei said it would power C919 verification flights “soon."3 If the engine works, the competitor Airbus faces in China is no longer constrained by a foreign engine supplier. It is constrained only by the rate at which Chinese industry can build.
